BACK

Alamosa to Antonito Transmission Line Rebuild Project

Project Updates

August 2024

Alamosa County construction starting soon

Following approval by Alamosa County in July, Xcel Energy plans to begin work in Alamosa County in October to rebuild nearly eight miles of the existing 69-kilovolt (kV) transmission line south of Alamosa Substation to the southern Alamosa County line. All work to rebuild the 69-kV transmission line will be completed in accordance with the conditions of approval included in the Alamosa County 1041 permit for the project. The rebuilt transmission line, it will provide safe, reliable and economical electric service to Alamosa County and surrounding communities.

Construction activities will include removal of some vegetation within construction areas, installation of foundations for transmission poles, setting of new transmission poles, stringing conductor and static wire, and restoration of construction areas.

Updates about the construction activities may be found on the project website –https://xcelenergytransmission.com/antonito–, along with a map of the Proposed Route and project information. You may also contact us with questions by calling (toll-free) 855-839-8865 or by email at AlamosaToAntonito@xcelenergy.com.

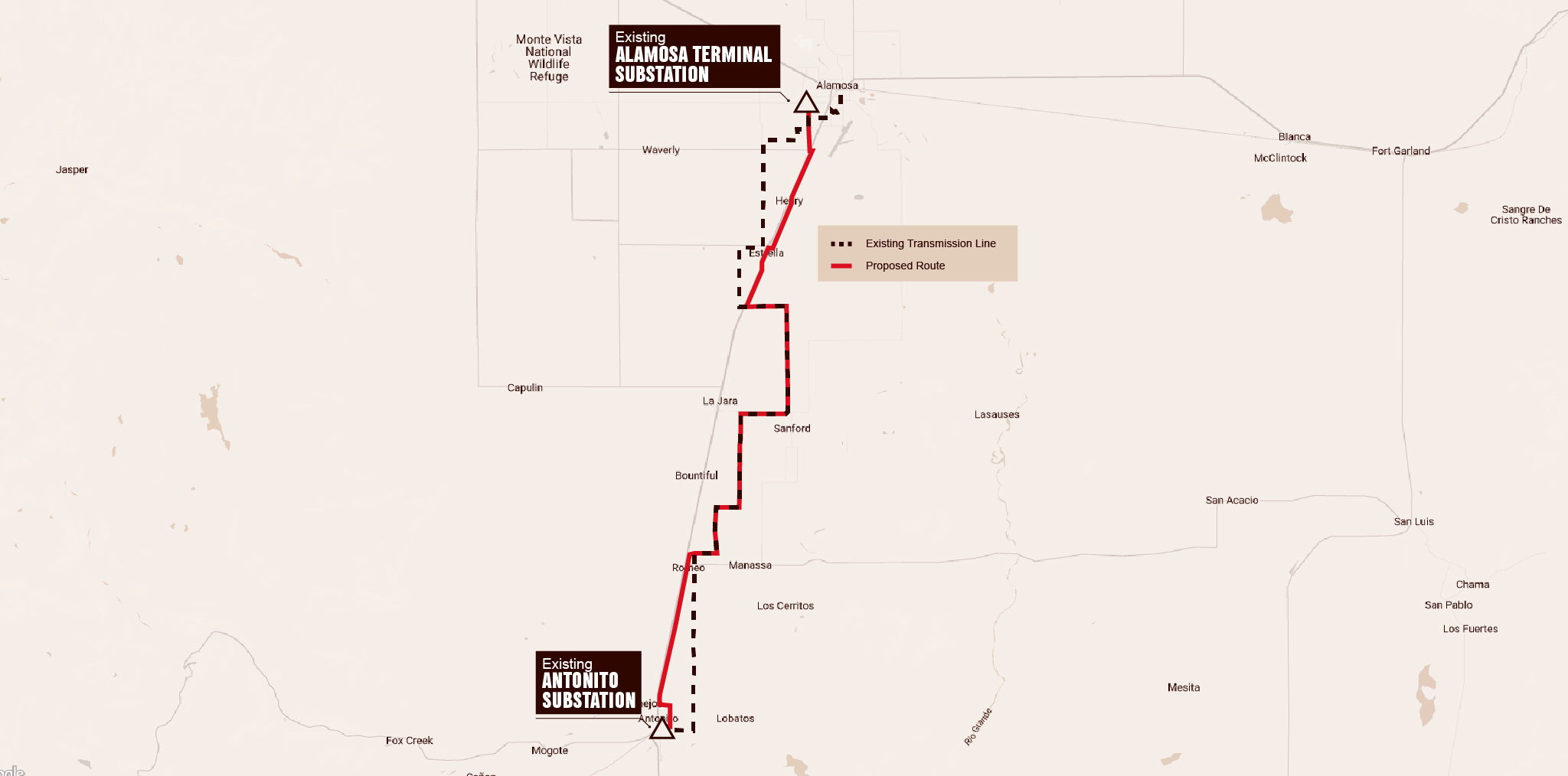

Map describes the construction detour information visually.

Project Overview

The Alamosa to Antonito Transmission Line Rebuild Project, announced in November 2021, involves replacing approximately 39 miles of 69-kilovolt (kV) electric transmission line between the Alamosa Terminal and Antonito substations (Project). Due to natural weathering and unscheduled interruptions in service, the wood pole structures, equipment and components that were installed more than 60 years ago need to be replaced. The new infrastructure will more effectively meet current and future customer energy needs, improve overall electric service to homes and businesses in Alamosa and Conejos counties and mitigate fire risk from extreme weather events.

The existing electric transmission line is critical to providing reliable service to customers and cannot be taken out of service while being replaced. For that reason, Xcel Energy initiated a study in the fall of 2021 to identify a new transmission line corridor that minimizes environmental and community impacts while meeting engineering and safety standards. The new transmission line will be rebuilt to current design standards that will improve system reliability, meet customer energy needs now and into the future, and reduce wildfire risk.

During the construction process, all existing structures and conductors (wires) will be removed and rebuilt with new fire-resistant steel structures that are built to specifications consistent with Xcel Energy’s systemwide design, new conductors and new optical ground wire (OPGW). The OPGW keeps our system smart by providing a communication channel to transmit system performance data to aid in faster, more efficient response times if power is interrupted. The OPGW also aids as a grounding source for lightning during storms. The project meets Xcel Energy system needs by installing new fire-resistant steel poles.

Permitting
On Jan. 25, Xcel Energy submitted a land use permit application to Alamosa County for Project approval. The Alamosa Board of County Commissioners conducted a public hearing concerning the permit on July 10, at the county courthouse, 8900 Independence Way. During the hearing, Commissioners voted to approve the land use permit. Pending approvals for construction permits, work on the project in Alamosa County may begin in late 2024
An application to Conejos County will be filed at a later date. Public hearings will be scheduled before the:

  • Conejos County Planning Commission and
  • Conejos County Board of County Commissioners following a recommendation by the Planning Commission

Xcel Energy’s right-of-way team is committed to working with affected landowners throughout the easement acquisition and construction process. Please contact us at the number or email below with questions you may have about the Project and how it may affect your property.

Typical Structures

Steel Poles

Project Schedule

  • Transmission routing study: September 2021 – March 2022
  • Public outreach: October 2021 – Project Completion
  • Final round of open house meetings: July – August 2023
  • Preferred route selection: Fall 2023
  • Permitting: Spring 2024, 2025
  • Surveying and easement procurement: Fall 2022 – Fall 2025
  • Construction: 2024 - 2025
  • In Service: 2026

Contact

alamosatoantonito@xcelenergy.com | 1-855-839-8865
