Ashland-Ironwood Transmission Line Relocation

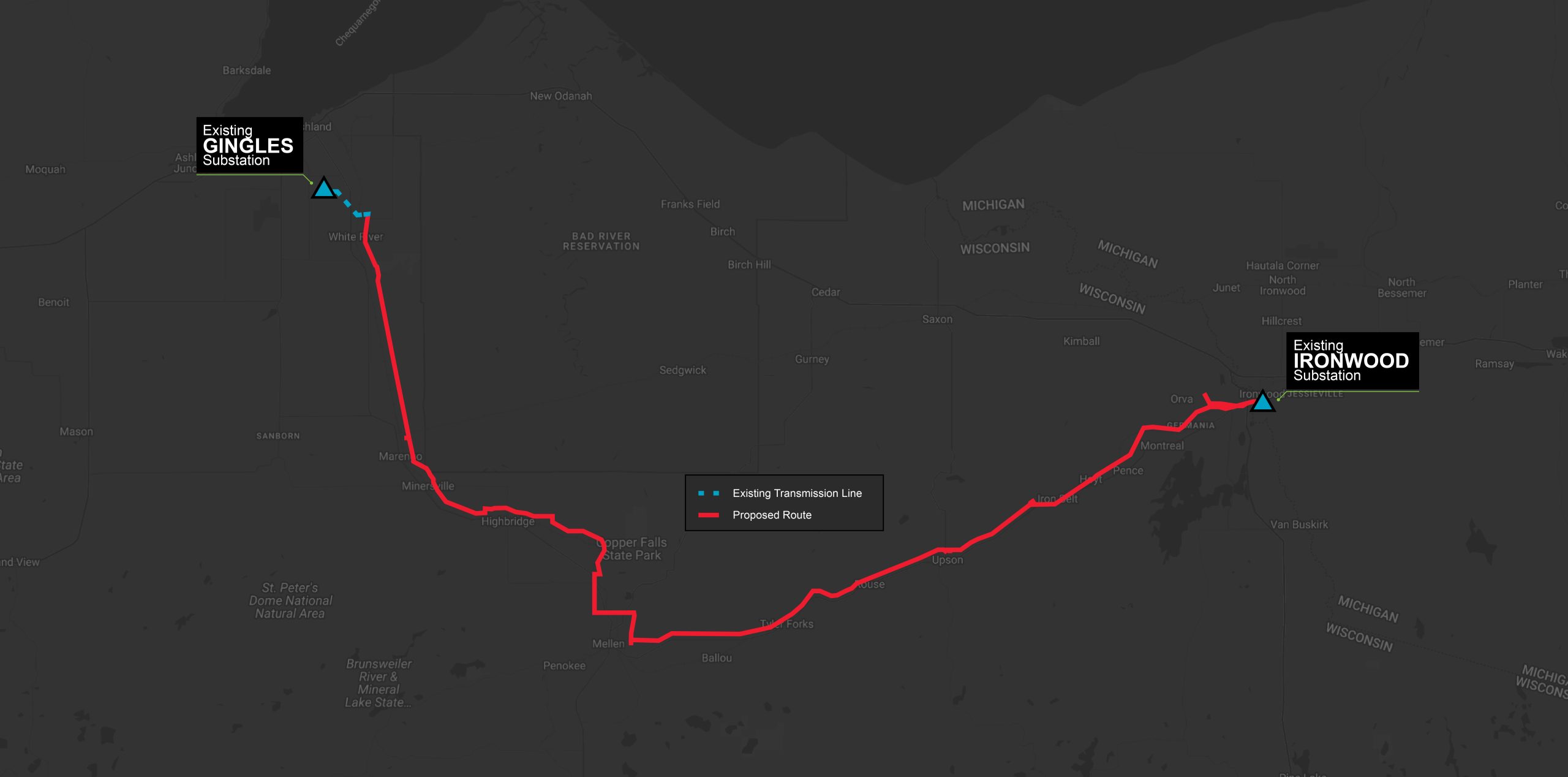

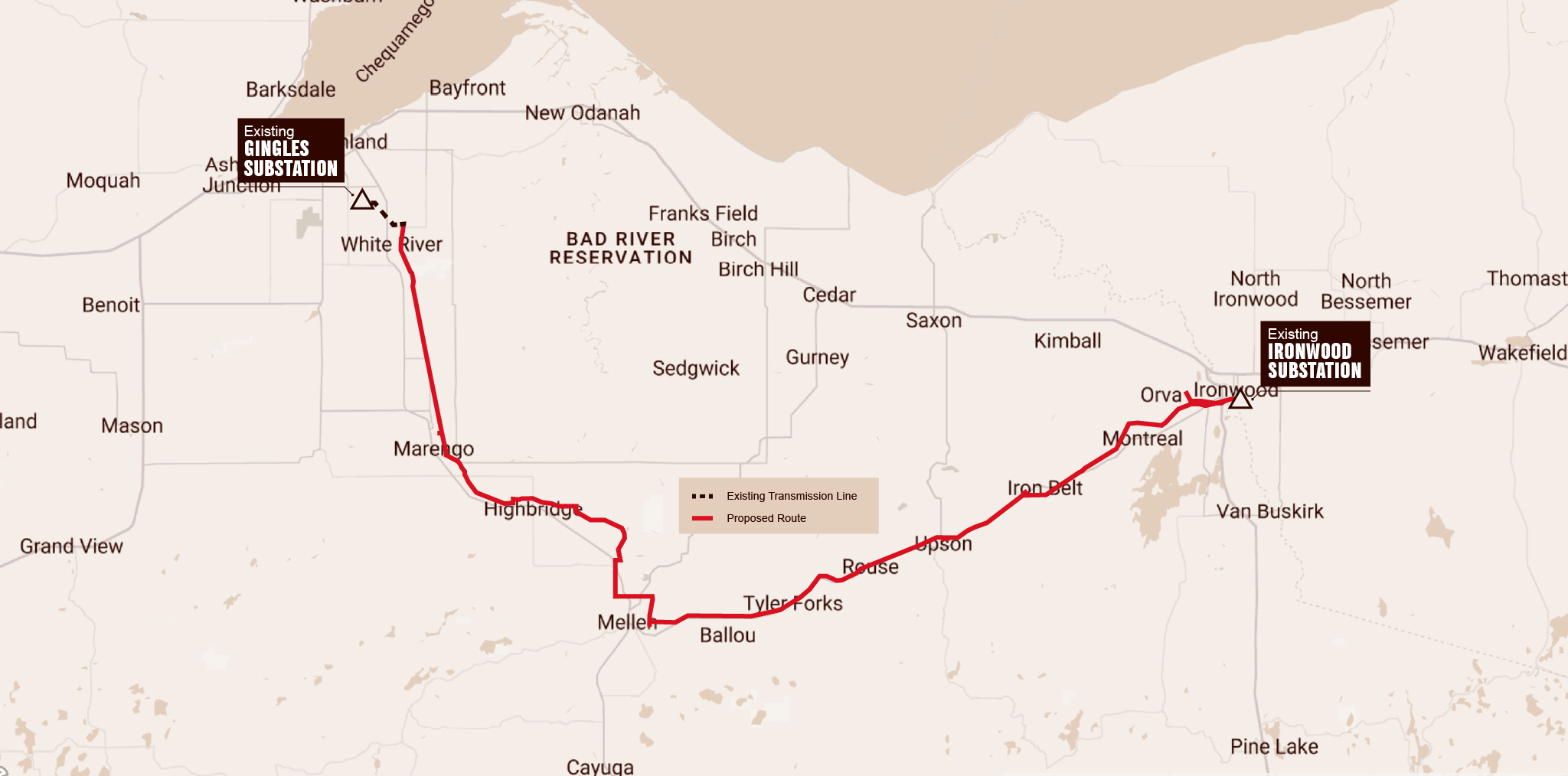

Ashland Ironwood project visual map black red

Project Overview

Xcel Energy is relocating and rebuilding two 35-mile transmission lines between the existing Gingles Substation and the Ironwood Substation. The transmission lines have reached the end of their useful lives and need to be replaced to continue providing reliable electricity for customers in the area.

An 88 kV line was built in the 1950s and a 115 kV line was built in the 1970s. Both lines are critical to providing reliable power to northern Wisconsin and Upper Peninsula Michigan including Xcel Energy, Bayfield Electric and Price Electric customers. However, due to natural weathering and other factors, the wood pole structures are approaching the end of their useful service life. Additionally, approximately 90 percent of the lines run cross-country on separate corridors through difficult terrain features including wetlands, beaver ponds, bogs, rivers, steep ravines and rocky outcroppings that pose challenges for construction and maintenance.

Project Update

March 5, 2025

Survey and geotechnical crews are conducting field reviews that will provide information about soil types, environmental information and other data that will assist with developing the transmission line’s final design. We are awaiting PSC approval of final minor route modifications and updating project costs, in part due to the modifications. Construction is expected to begin in August 2025.

E-subscribe to receive future notices from the PSCW (external link) during the construction/compliance phases of the project under PSC docket number 4220-CE-183.

November 13, 2024

Xcel Energy filed a project cost scope and schedule update with the PSC to reflect refinements to each of those project facets following detailed project development.

April 17, 2024

Xcel Energy modified the route following conversations with landowners and discussing the project status with the Public Service Commission of Wisconsin. We have asked for approval to make minor route modifications and updated project costs, in part due to the modifications.

April 15, 2022

The PSCW selected Route E and granted a CPCN permit. Xcel Energy will be working with landowners to secure easements and applying for permits needed to build the project. Xcel Energy has retained Steigerwaldt Land Services to acquire the necessary easements. Project land acquisition agents from Steigerwaldt began discussions with impacted landowners to acquire the necessary easements for the construction of the project. Project land acquisition have been contacting landowners along Route E to discuss the project, how it affects each property and to answer questions. We will attempt to address any issues raised to reach a mutually acceptable easement agreement.

May 26, 2021

Xcel Energy filed a Certificate of Public Convenience and Necessity application for the proposed Ashland-Ironwood Transmission Relocation project with the Public Service Commission of Wisconsin (PSCW). We thank landowners and stakeholders in the area for participating in our public open houses and providing us with valuable feedback on route options over the past two years. The application includes five route options labeled as A, B, C, D and E. Xcel Energy’s application with the PSCW can be viewed on the PSCW website (external link).

Project Details

The new transmission line route will follow Highway 13 from south of Ashland to Highway 77 near Mellen and then into Hurley and Ironwood. The new lines would be built in the general area around existing rights-of-way between Ashland and Mellen and Mellen and Ironwood. The project will eliminate the transmission lines that cross the Bad River Indian Reservation and remove a 1.8-mile-long segment located in the Copper Falls State Park. Construction is expected to begin in August 2025, with expected completion in 2028.

General Construction Expectations by Locality

  • Preliminary construction 8/2025 – 12/2025
  • Clearing 1/2026 – 3/2026
  • Remaining construction 2/2027 – 6/2027

  • Clearing 10/2025 – 12/2025
  • Construction East 10/2025 – 4/2026
  • Construction West 6/2027 – 10/2027

  • Clearing 11/2025 – 2/2026
  • Construction 6/2026 – 9/2026

  • Clearing 1/2026 – 3/2026
  • Construction 9/2026 – 2/2027

  • Clearing 11/2026 – 2/2027
  • Construction 8/2027 – 1/2028

  • Clearing 1/2027 – 3/2027
  • Construction 3/2028 – 5/2028

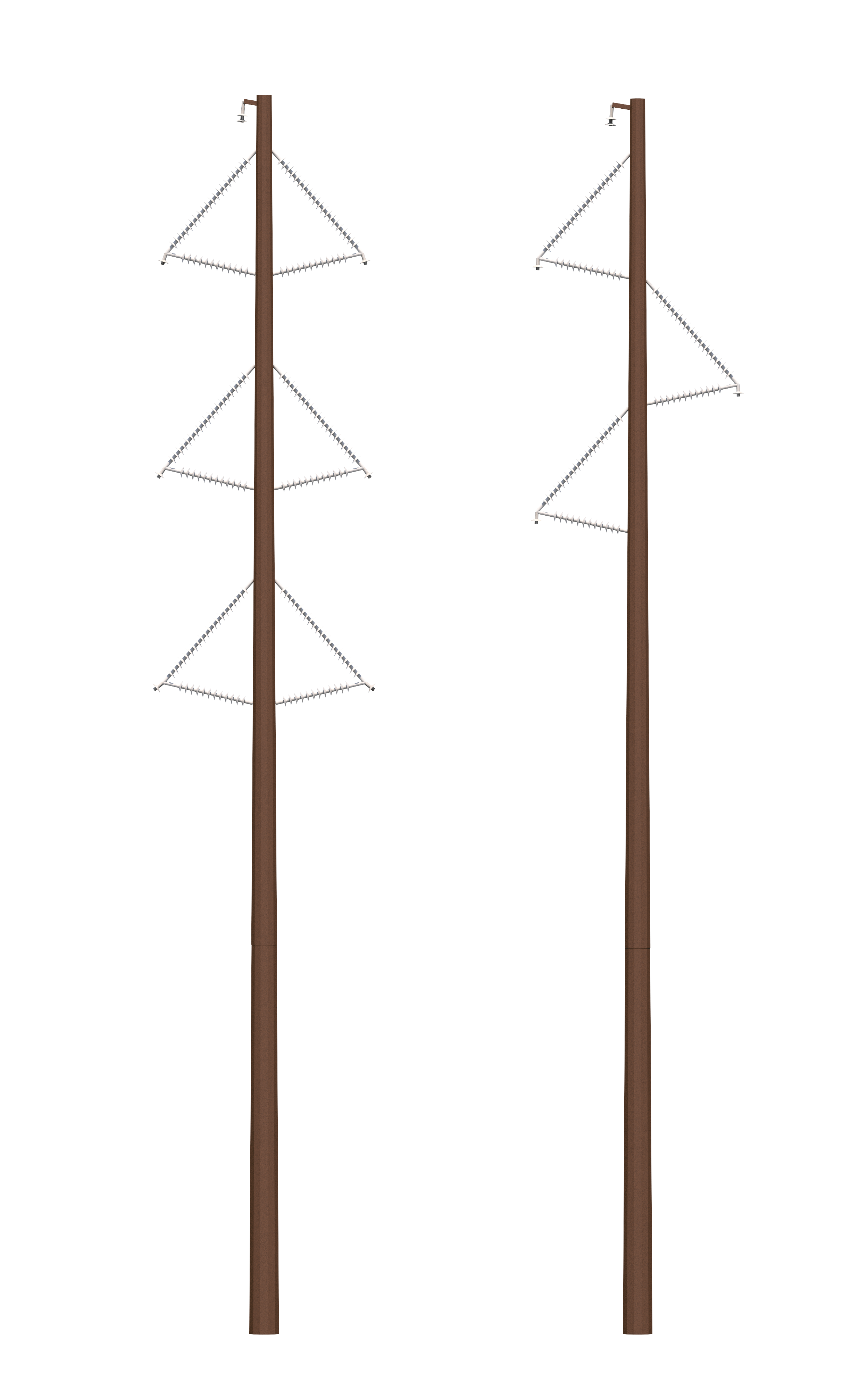

Typical Structures

Majority Single Pole
Circuit Configuration: Single or Double

Updated Timeline

  • Construction: 2025 - 2028
  • Removals/restoration/project closeout: 2028 - 2029
